Your Complete Home Renovation Center Guide for 2026

A one-stop home renovation center is the right choice for most homeowners who want a single point of accountability from the first design sketch through final installation. Instead of juggling a general contractor, a tile supplier, a cabinet dealer, and a flooring installer separately, you work with one team that handles design, materials, and project management under a single contract. The short answer: if you want fewer vendors, less coordination stress, and in-person product selection all in one place, a full-service center is built for you.

Who benefits most:

  • Homeowners who prefer one contract and one point of contact for the entire project
  • Anyone who needs permit handling, licensed trade coordination, and project management without hiring a GC separately
  • Buyers who want to see and touch cabinet finishes, countertop slabs, and flooring samples before committing
  • Families working within a defined budget who need package pricing and financing options

Your immediate next step: Schedule a showroom consultation at The Kitchen, Bathroom & Flooring Store. Bring a rough budget range, a list of must-haves, and any photos or floor plans you already have. The team will walk you through design options, product samples, and a realistic project timeline in a single visit.


Table of Contents

What does a one-stop home renovation center actually do?

A full-service remodeling center covers every phase of your project so you never have to source a separate vendor for design, materials, or labor.

Project manager reviewing renovation blueprints onsite

Design services are where most projects start. In-showroom consultations let you work with a design assistant to build out mood boards, compare cabinet door styles, and finalize countertop and tile selections before a single wall comes down. That upfront clarity prevents costly mid-project changes.

Material and product supply covers the full range: cabinets with soft-close doors and dovetail drawers, quartz and granite countertops, tile and stone, hardwood, laminate, luxury vinyl plank, vanities, fixtures, and appliance coordination. Seeing samples side by side in a showroom is genuinely different from ordering online. You can feel the weight of a cabinet door, compare grout lines on tile, and hold flooring planks against a paint chip in natural light.

Infographic showing key milestones in home renovation process

Turnkey installation means the center manages demolition, licensed trade coordination (electrical, plumbing, HVAC), permitting support, and final installation. You do not hire a plumber separately. You do not chase an electrician for a rough-in inspection date. The center owns the schedule.

Package offerings bundle design, materials, and installation at a fixed price, often with promotional financing. Individual line-item installs are also available for homeowners who have already purchased materials. Either way, special financing options make it easier to manage cash flow across a multi-week project.


How does a center-managed remodel actually run?

Every project follows the same core sequence: consultation → design freeze → permits → demolition → rough-in trades → inspections → insulation → drywall → finishes → punch list. Understanding where you are in that sequence, and what decisions you own at each stage, keeps projects on track.

  1. Consultation and scope definition. You meet with the design team, review your space, and agree on scope. This is where you decide what is in and what is out. Scope creep after this point is the leading cause of budget overruns, so be specific.
  2. Design and material selections. Cabinet layouts, countertop slabs, tile patterns, fixture specs, and flooring are finalized. Long-lead items like custom cabinetry and specialty tile are ordered here, before permits are even submitted.
  3. Permitting. The center submits permit applications to your local Authority Having Jurisdiction (AHJ). Permits are typically required for structural, electrical, plumbing, and mechanical work; cosmetic like-for-like swaps are often exempt, but local rules vary. Permit approval can take anywhere from a few days to several weeks depending on your municipality.
  4. Demolition. Existing fixtures, cabinets, and finishes come out. The center documents existing conditions and flags any surprises (water damage, outdated wiring) before rough-in begins.
  5. Rough-in trades. HVAC runs first, then plumbing, then electrical. Sequencing errors are the single most expensive homeowner mistake; doing steps out of order creates rework that costs more than the original work.
  6. Inspections. Rough-in work must pass inspection before walls close. Never let drywall go up before the inspector signs off.
  7. Insulation, drywall, and paint. Once inspections pass, walls close and finish surfaces begin.
  8. Cabinets, countertops, and finishes. Cabinets are set, countertops are templated and fabricated, tile is installed, and flooring goes down.
  9. Punch list. A final walkthrough identifies any incomplete or deficient items. Do not release final payment until every punch-list item is closed and you have received lien waivers.

Typical timelines: a bathroom remodel runs 3–6 weeks; a kitchen remodel takes 6–12 weeks; a full gut or whole-house remodel can run 8–18 months from permit application to move-in, depending on scope and lead times.

Pro Tip: Order cabinetry, windows, and appliances as soon as your design is frozen and permits are submitted. Custom cabinets often carry 6–10 week lead times. If you wait until the permit is approved, you will sit in a gutted kitchen for weeks waiting on boxes.


Which milestones should you track during your remodel?

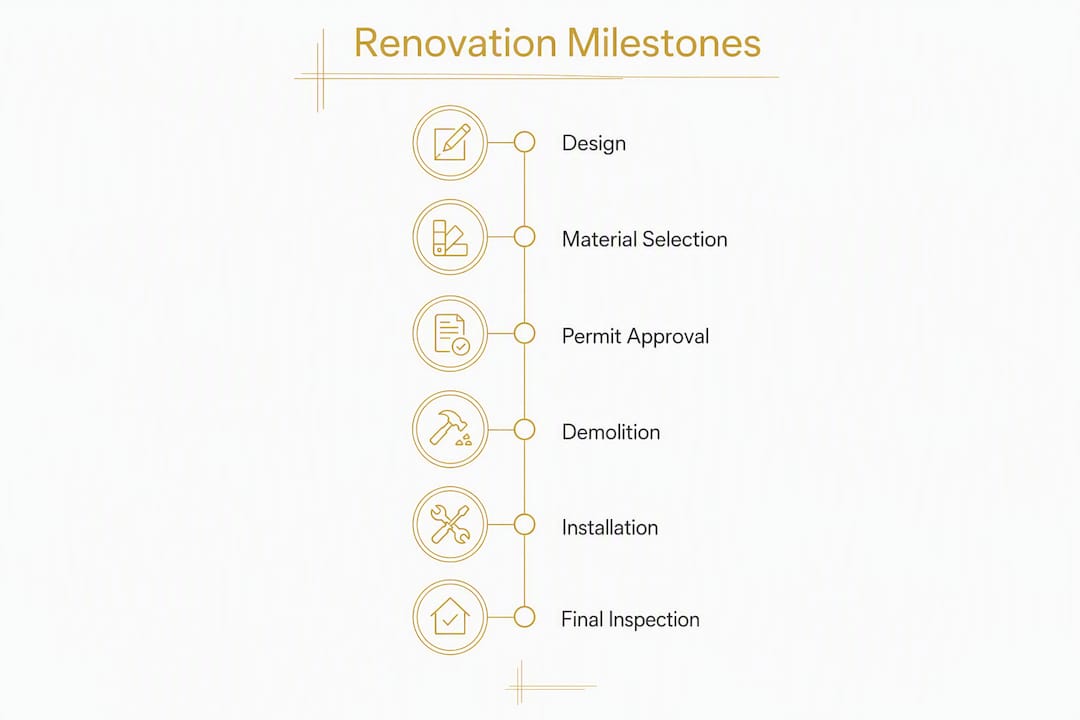

Track a handful of milestones rather than daily task lists. Permit approval, demo complete, rough inspection passed, drywall complete, cabinets set, countertops templated, and punch-list walkthrough are the events that actually tell you whether your project is on schedule.

Homeowner reviewing remodel milestones checklist

Milestones matter more than daily color updates because they are tied to inspections and fabrication events that cannot be faked. When rough-in passes inspection, you know the walls can close. When countertops are templated, you know the cabinets are set at final height and the fabricator has real measurements. A milestone-based check-in approach also keeps communication productive: ask your project manager weekly, “What changed, what is now on the critical path, and what decisions do you need from me?” That single question surfaces problems before they become delays.

Your actions at each milestone are specific. When permits are submitted, confirm that long-lead items are already on order. When demo is complete, walk the space and approve any scope changes in writing before rough-in begins. When rough-in passes inspection, release the corresponding milestone payment. When cabinets are set, schedule the countertop template appointment immediately so fabrication does not stall.

On payment: tie every progress payment to a passed inspection or a completed milestone, not to a calendar date. Withhold final payment until the punch list is fully closed and you have received signed lien waivers from all subcontractors. This is your primary financial leverage throughout the project.


What does a center-managed remodel actually cost?

Expect wide ranges depending on scope. A cosmetic refresh, a mid-range remodel, and a full gut renovation have very different cost profiles, and the 30% rule is a helpful guideline, not a hard cap. The rule suggests keeping total renovation spending below 30% of your home’s current market value to avoid overcapitalization. For a $400,000 home, that means staying under $120,000. But if your roof, HVAC, or electrical needs replacement, those systems come first regardless of the percentage.

Project Type Typical Cost Range Per-Sqft Band Notes
Cosmetic refresh (whole house) $30,000–$80,000 $15–$40/sqft Paint, fixtures, flooring, hardware
Mid-range remodel $100,000–$250,000 $50–$125/sqft New cabinets, countertops, updated systems
Full gut renovation $200,000–$500,000+ $100–$200+/sqft Structural, full systems, all finishes
Kitchen remodel (standalone) ranges from minor refresh to full custom build-out varies Minor refresh to full custom build-out
Primary bathroom remodel generally consistent with midrange projects varies Midrange; full spa bath runs higher

Source: CostPrism 2026 full-house renovation cost breakdown

Budget benchmark: Labor typically represents 35–50% of total project cost in most markets. Plan your contingency at 10–20% of total budget, with older homes leaning toward the higher end.

Kitchen renovations typically recoup 50–80% of their cost at resale; a midrange bathroom remodel recoups roughly 60–70%. Those returns make kitchens and bathrooms the strongest investment categories for most homeowners.

Financing paths include home equity loans, HELOCs, personal loans, and in-store financing plans. Some homeowners also explore rolling renovation costs into their mortgage, which can simplify cash flow for larger projects. The Kitchen, Bathroom & Flooring Store offers monthly payment plans and promotional financing tied to package purchases.


How do you pick the right renovation center?

Choose the center that can show proof across four areas: licensing and insurance, a portfolio with real before-and-after photos, a written contract with milestone-based payments, and in-showroom design support. Any center that cannot produce all four is a risk.

Questions to ask at your first consultation:

  • Who holds the general contractor license, and can I verify it?
  • How are subcontractors vetted, and are they insured?
  • What warranties do you offer on labor and materials?
  • How are change orders handled, and what is the approval process?
  • What is the milestone payment schedule, and which milestones trigger each payment?

Red flags to watch for:

  • Vague scope of work with no line-item detail
  • Payment requests tied to calendar dates rather than completed milestones
  • No permits pulled by the center, or unclear insurance and lien-waiver policies
  • Missing written warranty or no portfolio of completed projects
  • Pressure to sign before you have a written estimate

What a good showroom consultation looks like: you walk through material samples, discuss design options, receive a rough budget range, and leave with an itemized written estimate that ties each payment to a specific milestone. A structured plan developed before work begins is what separates a smooth remodel from a chaotic one.

For tasks like demolition, painting, or same-location fixture swaps, some homeowners choose to self-perform. Licensed trades should always handle electrical, plumbing, gas, HVAC, waterproofing, and structural work for code compliance and warranty protection. A reputable center will be clear about which scopes require licensed professionals and which are optional for homeowners to take on.


Why The Kitchen, Bathroom & Flooring Store stands out as a one-stop option

The Kitchen, Bathroom & Flooring Store is a full-service showroom in Jacksonville, FL, offering design consultation, material selection, professional installation, financing, and aftercare under a single contract. You do not need to hire a separate GC, source your own tile, or find an independent installer.

Concrete proof points:

  • Showroom: Walk in and compare cabinets, countertops, tile and stone, hardwood, laminate, luxury vinyl, and vanities side by side. The flooring selection alone covers every major category.
  • Kitchen packages: Fixed-price kitchen remodeling packages bundle design, materials, and installation so you know the cost before demolition begins.
  • Bathroom packages: Shower and tub installations, vanity upgrades, and full bathroom remodels are available as packaged services with clear scope and pricing.
  • Financing: Monthly payment plans and promotional financing are available through the store’s financing program.
  • Licensed and insured: The store works with licensed contractors and carries appropriate insurance coverage, giving you the protection you need on a permitted project.
  • Warranties and aftercare: Written warranties on labor and materials, plus documented punch-list closeout, mean your project does not end at installation day.
  • Client testimonials and portfolio: Before-and-after project photos and client reviews are available to review before you commit.

The consultation and project management process aligns directly with the milestone approach described earlier in this guide. You agree on scope, selections are finalized before permits are submitted, and payments are tied to completed milestones rather than calendar dates.


Key Takeaways

A one-stop home renovation center reduces coordination risk and keeps your project on schedule when you track milestones, budget realistically, and verify credentials before signing.

Point Details
One contract, one team Centralizing design, materials, and installation eliminates the coordination gaps that cause delays and cost overruns.
Milestone payments protect you Tie every progress payment to a passed inspection or completed milestone, and withhold final payment until lien waivers are received.
Use the 30% rule as a guideline Keep total renovation spending below 30% of home value, but prioritize systems (HVAC, electrical, plumbing) over cosmetic upgrades when both compete for budget.
Labor runs 35–50% of total cost Budget your contingency at 10–20% of total project cost, with older homes requiring the higher end.
The Kitchen, Bathroom & Flooring Store A Jacksonville, FL full-service showroom offering design, materials, installation, financing, and aftercare under one contract.

Why one-stop centers earn their premium

Most homeowners underestimate how much of a remodel’s cost comes from coordination failures rather than the work itself. A tile order arrives late because nobody confirmed the lead time. An electrician shows up before the plumber finishes rough-in. A countertop template gets scheduled before cabinets are fully set, producing a slab that does not fit. Each of these errors is preventable, and every one of them costs money.

The conventional wisdom says you save money by hiring trades separately and acting as your own GC. Sometimes that is true for very small projects. For a kitchen or bathroom remodel of any real scope, the math usually flips. The time you spend sourcing, scheduling, and resolving disputes between independent vendors has a real cost, and the risk of sequencing errors is entirely yours to absorb. A full-service center prices in that coordination, and for most homeowners, it is worth it.

What actually matters is not whether you use a center versus independent trades. It is whether whoever manages your project understands sequencing, pulls permits correctly, and ties payments to milestones. Those three things predict outcomes more reliably than any other factor. Ask for proof of all three before you sign anything.


Ready to book your showroom consultation?

The Kitchen, Bathroom & Flooring Store makes the path from idea to finished room straightforward. Book a showroom consultation and you will walk through material samples, discuss your design options, get a rough budget range, and leave with a clear picture of your timeline and financing options. No pressure, no vague estimates.

The Kitchen, Bathroom & Flooring Store

To prepare for your visit, bring a rough budget range, a list of must-haves, and any photos or floor plans you have. The design team will help you prioritize selections, identify long-lead items to order early, and build a project scope that fits your budget. Kitchen remodeling packages and bathroom remodeling packages are available with fixed pricing and financing options, so you know exactly what you are committing to before work begins. Showroom appointment slots are limited, and an early design freeze reduces lead-time risk on cabinets and specialty materials. Schedule your consultation today and get your project moving in the right direction.


Useful sources and further reading

These resources cover budgeting, sequencing, and planning in more depth, and link directly to The Kitchen, Bathroom & Flooring Store’s service pages for next steps.

  • How to Plan a Home Remodel: Phase-by-Phase Guide — Covers trade sequencing, milestone tracking, and the weekly check-in framework. Best for homeowners who want to understand project flow before their first consultation.
  • Full House Renovation Cost 2026 (CostPrism) — Detailed cost benchmarks by scope and per-sqft, with timeline bands for bathroom, kitchen, and whole-house projects.
  • The 30% Rule for Home Renovations (Yahoo Finance) — Explains the rule, its limits, and how to apply it alongside neighborhood ceiling values.
  • Step-by-Step Renovation Planning (The Renovation Blueprint) — Practical workbook-style guide for defining scope, sequence, and key decision points before work begins.
  • Home Remodel Decision Workbook (Remodel Upgrade) — Free planning workbook covering scope, budget, and risk identification; useful for 6–8 weeks of pre-construction planning on smaller projects.
  • The Kitchen, Bathroom & Flooring Store Showroom — Book a consultation, browse packages, and explore financing options for your Jacksonville-area remodel.
  • Bathroom Renovation Cost Tips — Practical cost-saving strategies for bathroom projects from the store’s own blog.
